Forklift Manufacturing Process Explained: How Long Does It Take to Manufacture a Forklift?

Views : 2
Update time : 2026-08-06

When purchasing a forklift from an overseas manufacturer, one of the most important questions buyers ask is:

How long does it take to manufacture a forklift?    products link

For international buyers, forklift delivery time directly affects warehouse planning, construction schedules, project progress, and inventory management.

However, many buyers misunderstand what a forklift supplier means by "lead time".

When a China forklift supplier provides a delivery time of 30 days, does it mean the forklift will arrive at your warehouse within 30 days?

The answer is no.

Forklift lead time usually refers to the period from order confirmation to forklift completion at the factory. It includes engineering confirmation, component preparation, manufacturing, assembly, testing, and export preparation.

Understanding the forklift manufacturing process helps overseas buyers evaluate whether a supplier's delivery promise is realistic and avoid unnecessary delays.



What Is Included in Forklift Supplier Lead Time?

A complete forklift delivery schedule usually consists of:

Forklift Production Time + Export Preparation + Ocean Shipping + Customs Clearance + Local Transportation

Among these stages, forklift production time is controlled by the manufacturer.

Ocean freight and customs clearance depend on shipping routes, ports, and local regulations.

A professional forklift supplier should clearly explain which parts are included in the quoted lead time.

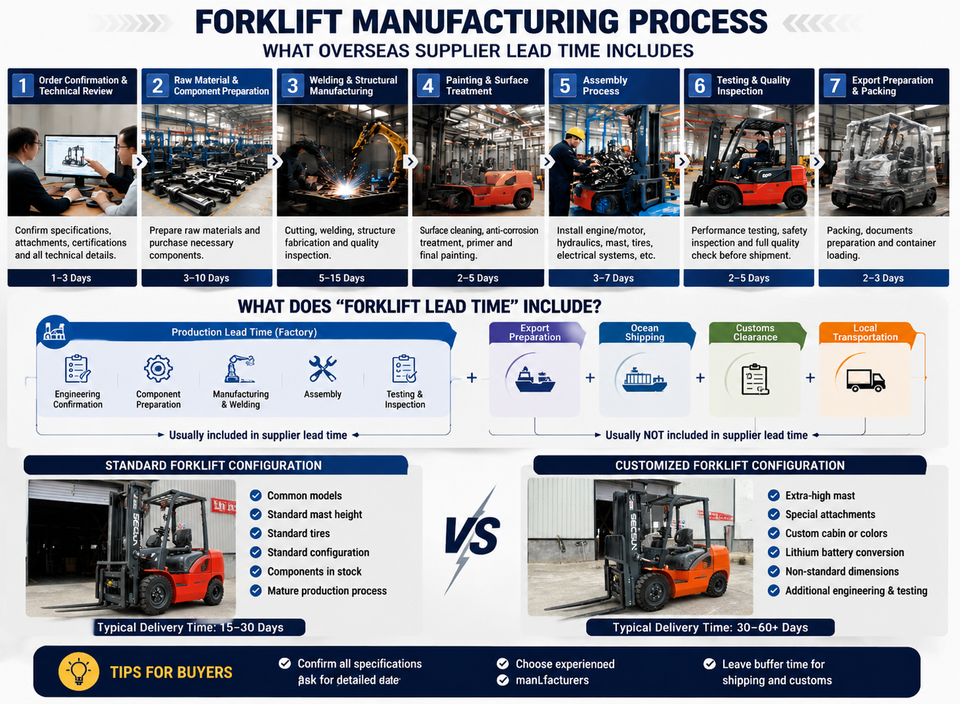

Complete Forklift Manufacturing Process

The forklift production process involves multiple steps, from technical confirmation to final quality inspection.

1. Order Confirmation and Technical Review

Estimated time: 1-3 days

Before forklift manufacturing begins, the supplier needs to confirm all technical specifications.

Important details include:

  • Forklift capacity

  • Diesel, LPG, electric, or lithium battery system

  • Mast lifting height

  • Fork dimensions

  • Tire type

  • Cabin requirements

  • Attachments

  • Certification requirements

For example, a standard 3 ton diesel forklift with a 3 meter mast usually follows an existing production process.

However, a customized forklift with a 6 meter triplex mast, side shifter, fork positioner, or special attachments requires additional engineering confirmation.

This stage prevents production mistakes and ensures the forklift matches the customer's working environment.

2. Component Preparation and Supply Chain Management

Estimated time: 3-10 days

A forklift consists of hundreds of components.

The main components include:

  • Forklift frame

  • Mast system

  • Counterweight

  • Engine or electric motor

  • Transmission

  • Hydraulic system

  • Controller

  • Battery system

  • Tires

  • Safety components

For standard forklift models, experienced manufacturers usually have stable supply chains and common components available.

For customized forklift manufacturing, some special components may require additional purchasing time.

This is one of the reasons why custom forklift delivery time is usually longer than standard forklift delivery time.

3. Forklift Frame Manufacturing and Welding

Estimated time: 5-15 days

The forklift frame is the foundation of the machine.

The manufacturing process includes:

  • Steel cutting

  • Component positioning

  • Welding

  • Structural inspection

  • Surface preparation

High-quality forklift manufacturers pay special attention to welding quality because the frame directly affects:

  • Load capacity

  • Stability

  • Service life

  • Operator safety

Heavy-duty forklifts usually require more manufacturing time because of stronger structures and larger components.

4. Painting and Surface Treatment

Estimated time: 2-5 days

After welding, forklift components enter the painting process.

The process normally includes:

  • Cleaning

  • Rust prevention treatment

  • Primer coating

  • Final painting

For forklifts exported overseas, especially to humid or coastal markets, corrosion resistance is an important quality factor.

5. Forklift Assembly Process

Estimated time: 3-7 days

During forklift assembly, technicians install:

  • Engine system

  • Transmission

  • Hydraulic system

  • Steering system

  • Mast assembly

  • Fork carriage

  • Electrical components

  • Cabin and safety equipment

After assembly, technicians adjust the forklift performance to ensure:

  • Smooth lifting operation

  • Stable driving performance

  • Reliable braking

  • Accurate steering

6. Forklift Testing and Quality Inspection

Estimated time: 2-5 days

Before shipment, every forklift should complete factory inspection.

Common forklift quality tests include:

  • Load lifting test

  • Hydraulic system test

  • Driving test

  • Brake test

  • Steering test

  • Safety inspection

For customized forklifts, additional testing may be required.

For example:

A forklift equipped with a paper roll clamp, bale clamp, or rotator attachment requires additional hydraulic and load testing.

7. Export Preparation and Shipment

Estimated time: 2-3 days

After passing inspection, the forklift enters export preparation.

This includes:

  • Final cleaning

  • Documentation

  • Packing

  • Container loading

The supplier prepares export documents such as:

  • Commercial invoice

  • Packing list

  • Certificate of origin

  • Shipping documents

Standard Forklift Configuration vs Custom Forklift Manufacturing Time

One of the biggest factors affecting forklift delivery time is configuration.

Standard Forklift Configuration

Examples:

  • Standard diesel forklift

  • LPG forklift

  • Electric forklift

  • Standard mast height

  • Standard tires

Typical manufacturing time:

15-30 days

Reasons:

  • Existing production drawings

  • Available components

  • Mature production process

  • Faster assembly procedure

Standard forklift models are suitable for customers who need faster delivery.

Custom Forklift Configuration

Examples:

  • Extra-high lifting mast

  • Hydraulic side shifter

  • Fork positioner

  • Rotator attachment

  • Special cabin

  • Lithium battery conversion

  • Customized color

  • Special dimensions

Typical manufacturing time:

30-60+ days

Additional time may be required for:

  • Engineering confirmation

  • Special component sourcing

  • Manufacturing adjustment

  • Additional testing

How to Evaluate Whether Forklift Delivery Time Is Reasonable?

When comparing China forklift suppliers, buyers should not only focus on price.

Delivery reliability is also important.

Here are several practical methods.

Ask for a Detailed Production Schedule

A reliable forklift supplier should explain:

  • Production starting date

  • Component preparation period

  • Assembly schedule

  • Testing date

  • Shipping plan

A simple answer like "delivery in 20 days" without explanation may not be realistic.

Confirm Whether the Forklift Model Is Standard or Customized

Ask the supplier:

"Is this forklift already in regular production?"

A mature production model normally has shorter lead time.

A new customized forklift requires more preparation.

Consider Forklift Capacity and Application

Different forklift types have different manufacturing complexity.

For example:

A 2 ton electric forklift is easier to manufacture compared with a 20 ton heavy-duty diesel forklift.

Large forklifts require:

  • Stronger frames

  • Larger hydraulic systems

  • More complex components

Therefore, production time increases accordingly.

Consider Attachments and Special Equipment

Forklift attachments can affect production schedules.

Common attachments include:

  • Side shifter

  • Fork positioner

  • Paper roll clamp

  • Bale clamp

  • Rotator

Although attachments improve working efficiency, they require additional installation and testing.

Frequently Asked Questions About Forklift Manufacturing Time

How long does it take to manufacture a forklift?

The average forklift manufacturing time is usually 15-30 days for standard configurations and 30-60+ days for customized forklifts.

What does forklift lead time include?

Forklift lead time usually includes technical confirmation, component preparation, manufacturing, assembly, testing, and export preparation. It normally does not include ocean transportation and customs clearance.

Why do customized forklifts take longer to produce?

Custom forklifts require additional engineering design, special components, production adjustments, and additional quality testing.

How can I reduce forklift delivery time?

Buyers can reduce delivery time by confirming specifications early, selecting standard configurations, and working with experienced forklift manufacturers.

Conclusion

Understanding the forklift manufacturing process helps overseas buyers make better purchasing decisions.

Forklift delivery time is affected by many factors, including forklift model, configuration, production complexity, component availability, and quality requirements.

A professional China forklift supplier should provide a transparent production schedule and clearly explain what the quoted lead time includes.

Whether purchasing a standard electric forklift, diesel forklift, LPG forklift, or customized material handling equipment, understanding the complete forklift production process allows buyers to plan better and choose a reliable manufacturing partner.


Related News
Read More >>
SECSUN: A Trusted Chinese Construction Machinery Supplier for Global Markets SECSUN: A Trusted Chinese Construction Machinery Supplier for Global Markets
Aug .03.2026
SECSUN Machinery is a trusted China construction machinery supplier providing wheel loaders, excavators, forklifts and customized equipment solutions for global construction, logistics and industrial projects.
How to Import New Machinery from China to Colombia: A Complete Guide for Colombian Buyers How to Import New Machinery from China to Colombia: A Complete Guide for Colombian Buyers
Jul .28.2026
Learn how to import new machinery from China to Colombia, including forklifts, excavators, loaders and tractors. Complete guide covering documents, certifications, customs clearance and import requirements.
How to Import Construction Machinery from China: Complete Customs, Shipping & Documentation Guide How to Import Construction Machinery from China: Complete Customs, Shipping & Documentation Guide
Jul .21.2026
Learn how to import forklifts from China with this complete buyer guide. Discover how to choose reliable forklift manufacturers, compare costs, understand shipping, certifications, and avoid common mistakes.
Meet SOLI: SECSUN’s New Brand Ambassador for the Future of Industrial Machinery Meet SOLI: SECSUN’s New Brand Ambassador for the Future of Industrial Machinery
Jul .17.2026
A New Chapter Begins as SECSUN Embraces Brand Renewal with a Professional Industrial IdentitySECSUN Machinery is proud to announce the introduction of SOLI, the brand’s new mascot and visual ambassador, marking an important milestone in SECSUN’s upcoming brand transformation.As a global machinery
